Waste
Diversion from landfill
Project Targets | |
|
|
Performance | |
|

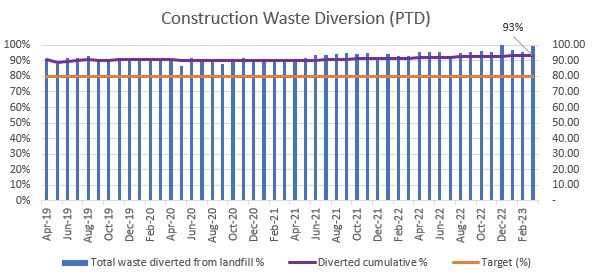

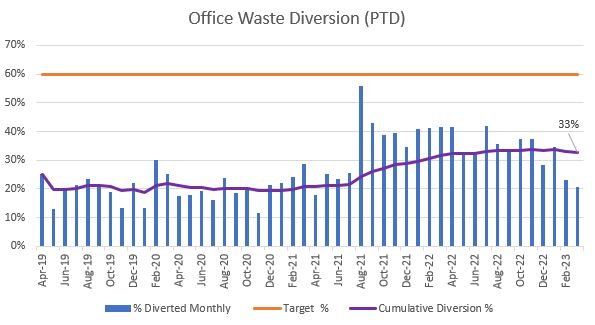

Construction and demolition waste represent one third of all waste sent to landfill in NSW. JHCPB’s efforts focus on reducing the Project’s contribution to landfill by recovering and reusing waste materials (on site and off site) as much as practicable. From the commencement of construction to March 2023, JHCPB has diverted 73,921.74m3 of construction waste from landfill (93%) and reused 9,115,290 tonnes of spoil (98%). Project spoil has been beneficially reused on site for civil works and at various approved offsite reuse sites, such as the Northern Roads Project and Western Sydney Airport. Annual waste to destination audits are also conducted for all waste streams. JHCPB is currently exceeding the 80% diversion target for construction and demolition waste. The subcontractor’s performance is tracked monthly. Annual waste to destination audits for construction waste are also conducted during construction. JHCPB are currently exceeding both construction and spoil diversion targets but the Project’s office waste diversion is performing under the target of (40%- 60%) sitting at 33%. However, several measures to improve office waste diversion have been implemented in the review period, including:
Mask recycling has been implemented outside the C&C of the WHT STW and M5 offices, this was implemented due to disposable masks being the largest waste stream of PPE on the project. This has had good success with low levels of contamination and compliance from the team Spoil Diversion Performance Landfill diversion rates for construction waste Office Waste Diversion |
