Water
Water consumption and non-potable replacement
Project Targets |
|
Performance |
Infrastructure projects require a significant amount of water for construction and operations. JHCPB’s Construction Water Reuse Strategy outlines the measures the Project will investigate to ensure water savings are realised during construction. Key initiatives to reduce potable water use during construction include:
As part of detailed design, JHCPB have identified the following initiatives to reduce water consumption during operations and replace potable sources with non-potable alternatives:

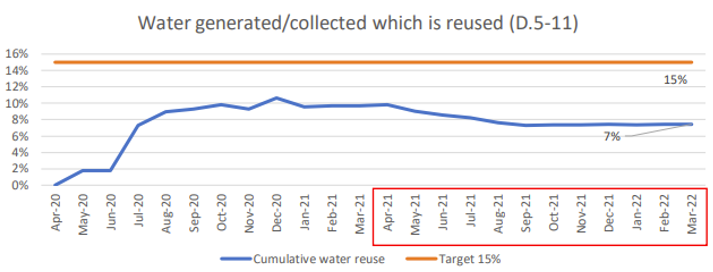

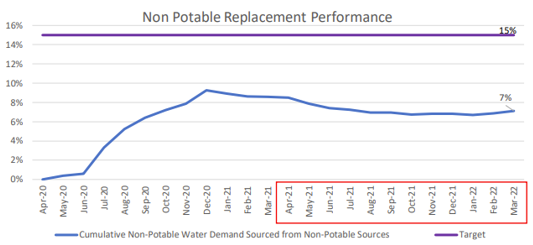

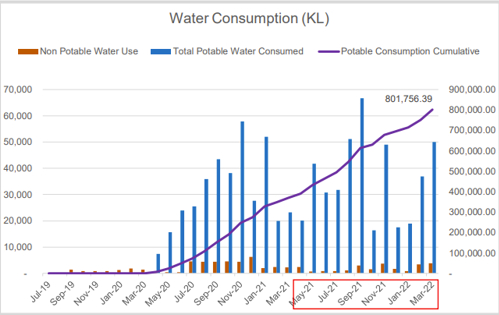

Commissioning on the Water Treatment Plant (WTP) at Site C took place in April 2020. Registers of tunnel water pumped to the WTP are kept and updated by tunnel construction teams. These registers are used by the Sustainability Team to track total water collected and reused by the Project. Performance against the Project targets is provided below: Monthly volumes of potable and non-potable water being used on the Project PTD Non-Potable Water Replacement Performance 2021-2022 Water Generated/Collected which is Reused-Performance 2021-2022
|
